The “7-Day Production” Myth and the High Cost of Speed

1. The “Amazon Prime” Effect on B2B Sourcing

In the era of on-demand retail, many new sportswear brands approach manufacturing with an e-commerce mindset: “I want it now.”

Factories, desperate to secure deposits, have adapted to this by promising unrealistic lead times (e.g., “Samples in 3 days, Bulk in 2 weeks”). While this sounds attractive to a founder launching a collection, seasoned procurement officers know that extreme speed is often a red flag for structural instability.

In high-performance technical manufacturing (specifically activewear), physics cannot be cheated. There is a hard limit to how fast a garment can be produced before the chemical and mechanical bonds fail.

2. The Anatomy of a Lead Time (Where the Time Actually Goes)

To understand why “2-week bulk production” is often a trap, buyers must look at the invisible steps in the Critical Path.

Phase 1: The Lab Dip (7-10 Days)

Before a single fabric roll is cut, the color must be matched. Dyeing is chemistry. It requires formulated “Lab Dips” to match your Pantone.

  • The Rush Risk: Factories skip the approval process and dye the whole batch “visually close.” Result: Your “Navy Blue” leggings arrive looking Purple under sunlight.

Phase 2: Fabric Relaxation (24-48 Hours)

Spandex and elastane fabrics are elastic. When unrolled from the bolt, the fabric is under tension. It must “relax” on the cutting table for at least 24 hours before cutting.

  • The Rush Risk: If a factory cuts immediately to save a day, the fabric shrinks after stitching. Result: Your “Size Large” shrinks to a “Medium” after the first wash.

Phase 3: Adhesive Curing (Technical Garments)

For modern heat-bonded or ultrasonic garments (Hyrox/Padel gear), the adhesive films (bonding tape) require specific dwell times to cure.

  • The Rush Risk: If a bonded pocket is packed immediately while still warm, the adhesive doesn’t set. Result: Delamination (peeling) occurs within 30 days of use.

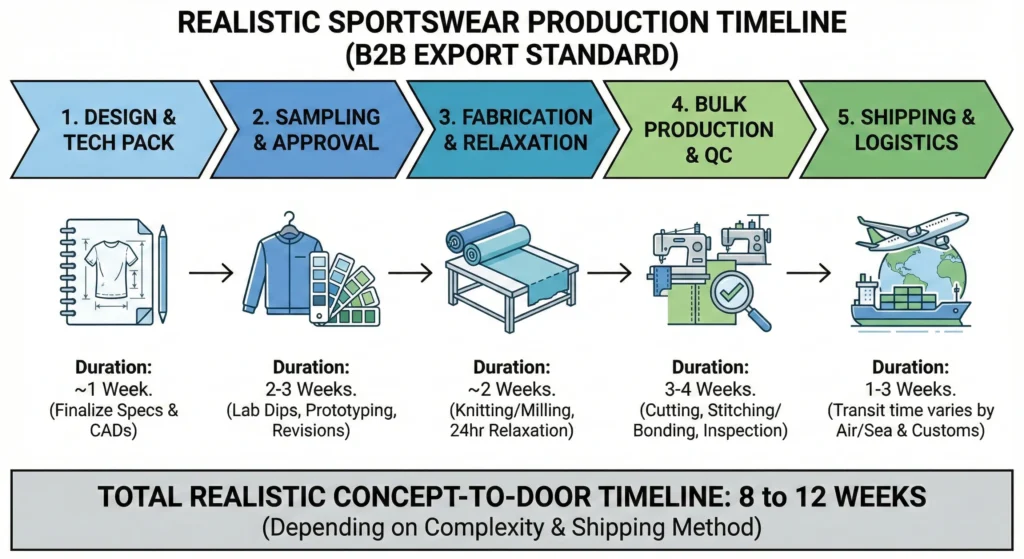

Sportswear Manufacturing Timeline Chart showing Design, Sampling, Fabrication, and Shipping stages.
Figure 1: The Critical Path. Rushing “Fabrication” is the #1 cause of garment shrinkage.

3. The “Bait and Switch” of Fast Sampling

A common industry tactic is the “Golden Sample.”

A factory promises a 5-day sample turnaround. To achieve this, they use “market fabric” (leftover stock from another brand) instead of knitting fresh fabric to your specs.

  • The Trap: You approve the sample because the fabric feels great.
  • The Reality: When you place the bulk order, they have to knit fresh fabric, which takes 20 days. Suddenly, your “2-week production” becomes 6 weeks, and the fabric hand-feel is different from the sample you approved.

Insight: A longer sampling lead time (14-20 days) usually means the factory is actually knitting custom fabric for you, ensuring the sample matches the bulk.

4. Red Flags: When to Walk Away

If you encounter these promises during negotiation, proceed with extreme caution:

  1. “We can copy this Lululemon fabric in 1 week.”
    • Reality: Developing a technical GSM and yarn blend takes 30-45 days of R&D. 1 week means they are giving you a generic stock substitute.
  2. “No MOQ, 7-day turnaround.”
    • Reality: No factory can pause a 5,000-piece production line to make your 50 pieces in 7 days. They will likely sub-contract your order to a smaller, lower-quality workshop (a “shadow factory”) to meet the deadline.
  3. “We don’t need a Tech Pack.”
    • Reality: This guarantees errors. A factory that accepts vague screenshots instead of CAD files is gambling with your capital.

5. The Exception: How Low MOQs and Fast Lead Times Are Actually Achieved

While creating custom fabric takes 30+ days and a fabric minimum, a shorter production cycle with a low Minimum Order Quantity (MOQ) is possible. However, it requires a strategic trade-off: using stock fabric.

If a brand wants both speed and small quantities (e.g., 50 pieces), the order has to skip the knitting and dyeing stages. Here is how that works:

A. The “Dye Bath” Constraint

Dyeing machines need a minimum load to hold a consistent shade, so every custom colour carries a fabric minimum.

  • The Custom Route: To get a custom “Slate Grey,” the mill has to knit and dye a run just for you. On imported performance fabric that minimum often works out around 1,000 pieces. Locally knitted fleece can go lower, which we break down in our custom hoodie MOQ guide.
  • The Stock Route: Sialkot has a large local market of ready-to-cut fabric, pre-dyed in standard colours (Black, Navy, Heather Grey).
    • The Benefit: Stock fabric is bought by the kilogram, only as much as the order needs, so the fabric adds no minimum. The only minimum left is the factory’s own cutting and sewing run.
    • The Trade-Off: You give up control over the exact shade. You cannot ask for “Midnight Navy”; you choose from the navies that are in stock.

B. The “White Base” Sublimation Method

For combat sports and team uniforms, low MOQs and shorter lead times come from sublimation on white polyester.

  • The Process: White polyester is kept in stock. Your design is printed onto it and transferred with heat before the panels are cut and sewn.
  • The Advantage: The fabric is already on hand, so it is not the bottleneck. Lead time comes down to printing and sewing capacity, and the minimum is the factory’s own run rather than a fabric minimum. At GYMHUR that is 50 pieces per style. If you need fewer, ask us.

Key Insight for Buyers:

You cannot have custom fabric at a low MOQ without paying for the unused dye-bath capacity.

High MOQ + Long Lead Time = Custom Fabric / Custom Color.

Low MOQ + Shorter Lead Time = Stock Fabric / Standard Color.

Even on the stock route, plan for around three weeks of bulk production after sample approval, plus shipping. The full breakdown is in the table below.

GYMHUR’s Actual Lead Times

These are the timelines we work to on our own orders, not industry averages.

StageTypical timeWhat changes it
Samples2–3 weeksDecoration method and fabric (below)
Screen print or silicone logosAdds about 2 weeksDone by specialist vendors outside the factory, so the garments travel out and back
DTF or vinyl logosAdds nothingApplied in-house during production
Lab dip for a custom colourAbout 10 daysColour approval before fabric is dyed
Custom fabricAbout 25 days, after the lab dipKnitting and dyeing a run for your order
Bulk productionAround 3 weeksOrder size and construction complexity
GYMHUR production timelines

Stock fabric with DTF or vinyl branding is the fastest route. Custom fabric with a screen-printed or silicone logo is the slowest, because the lab dip, the fabric run and the outside decoration each add time.

6. Strategic Advice for Brand Owners

The most profitable brands do not rely on “Rush Production.” They rely on Forecast Planning.

  • Plan 90 Days Ahead: If you want to launch in June (Summer), your bulk order should be placed in March.
  • Build “Buffer” Stock: Do not wait until you are sold out to reorder. The shipping logistics from Sialkot/China to the EU/USA can face random delays (Customs, Holidays).
  • Validate the Process, Not Just the Product: Ask your factory for their “Quality Control Checklist” (QC). If they can’t show you a documented curing process for their bonding machines, they are guessing.

If you are planning your first production run and want to understand realistic timelines, contact us directly — we’ll give you an honest timeline based on your specific product and fabric requirements. Our most common products for first-time brands are custom leggings, hoodies, and rashguards. For a full breakdown of how fabric specification affects your lead time, see our GSM fabric weight guide.Conclusion: Speed is a metric, but Consistency is the currency. A delivery that arrives 1 week late is annoying; a delivery that peels after 1 week is fatal to your brand reputation.
